Ada Street Greening
The City of Subiaco will soon be commencing street 'greening' construction works on Ada Street.
As a result, Ada Street will be closed from 29/10/2025 to 16/12/2025.
Work times will be 7:00am – 5:00pm
Project overview

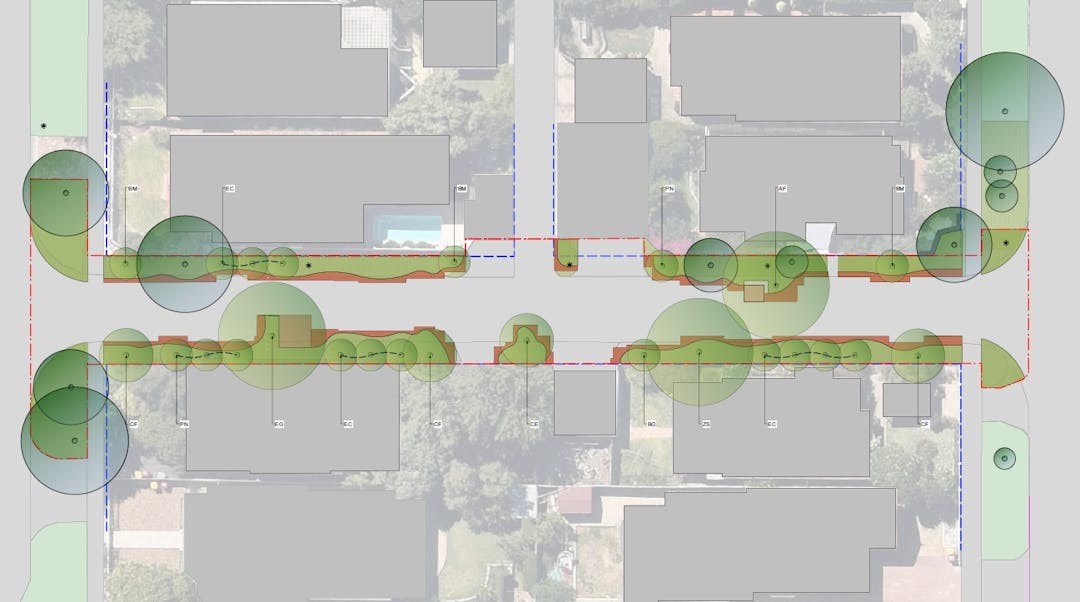

Works will include replacement of asphalt with a brick paved street surface, tree planting, addition of street furniture and additional landscaping to verges.
The project vision is to create a shared street environment based on self-explaining roads principles that slow traffic and create an informal public open space that elicits safe driver behaviour.
Benefits include:
Safer traffic environment
New garden beds in verges
New seating
Increased tree canopy and shade
Reduction of temperatures to reduce the urban heat island effect
Australian native plantings
Stormwater capture in garden beds, minimising stormwater runoff following Water Sensitive Urban Design Principles
Protection of existing trees
Bird nesting box
Consultation
The City and its consultant team worked collaboratively in consultation with surrounding residents to develop the project.
The consultation included engagement activities, the MARKYT Community Scorecard, the Urban Forest Strategy, and the City's Strategic Community Plan consultation sessions.
The project will deliver on the following aspirations such as:
Delivering spaces that prioritise people, safety, access and connectivity
Strengthen climate resilience response through water-sensitive landscaping and infrastructure
Protect and grow the City’s green network through tree canopy, smart plantings and green links
Enhance streets and laneways as safe, walkable places for people
More details about the project are available here: Ada Street Greening Project | Have your say Subiaco .
Project timeline
Community consultation was undertaken from 8 May to 27 May 2024
The tender for the work was called in April 2025
The construction contract was awarded in June 2025
Procurement of materials is occurring (June through December 2025)
Street closure will be active from 29/10/2025 to 16/12/2025
Demolition of the road surface will be completed in early November 2025
Construction of all civil works for the project is anticipated to be complete by the end of December 2025
Should you have any questions about the project, please contact the Project Lead: ParksCoordinator@subiaco.wa.gov.au
